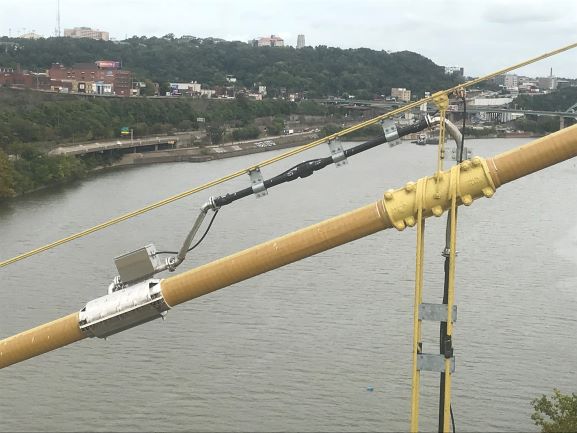

In 2017, American Bridge was awarded the contract for the rehabilitation and dehumidification of the South 10th Bridge. The 1,275-foot suspension bridge crosses the Monongahela River in downtown Pittsburgh. Dehumidification, a relatively new technology in North America, involves blowing dry air through the main cables to reduce the relative humidity, inhibiting the development of corrosion.
American Bridge’s scope included main cable and anchorage dehumidification, main cable elastomeric wrap installation, anchorage vault roof reconstruction, roadway and sidewalk reconstruction, concrete repairs, expansion dam replacement, main deck asphalt and waterproofing membrane replacement, and other miscellaneous rehabilitation items.
The project team broke the work into two phases, the east side and west side of the bridge. Varying lane closures of the bridge and surrounding streets were required to complete the structural and cable rehabilitation. The bridge remained open to traffic as it is a major connection between downtown Pittsburgh and South Side. Because it is in a congested area, safety has been a top priority throughout the project. American Bridge coordinates maintenance and protection of traffic efforts with the County and City of Pittsburgh authorities to avoid impacts during heavy traffic times.

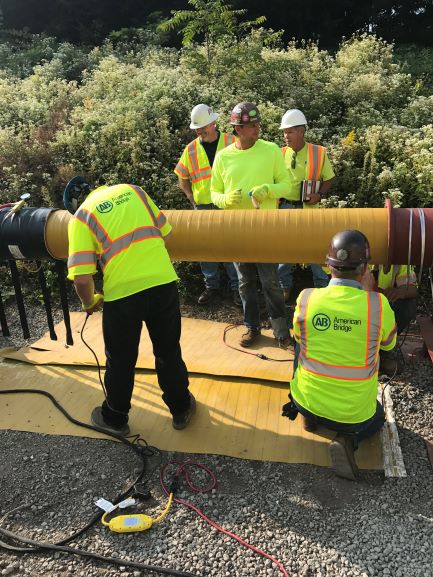

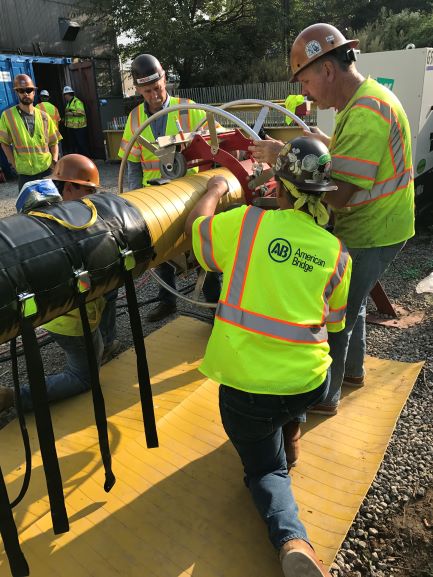

Training was held to demonstrate the different tasks required on dehumidification works. Ironworkers were successfully trained how to warp and seal cables, and install wedges and injection/exhaust sleeves. A new technique for this Ironworker crew was cable wire splicing. Each cable on 10th Street is made up of more than 4,000 wires about four millimeters in diameter. When these cable wires rust or break, they need to be repaired. AB was tasked with splicing and tensioning wires along the main cable, specifically within the splay chamber of the South Anchorage. Specially-fabricated wire ferrules were used to splice new wire to the existing damaged wires. Turnbuckles tensioned the wires to roughly 5 kips and secured with a specialized hydraulic press.
The project has a challenging schedule with the critical path flowing through the painting operations, which are governed seasonally by weather, and then into the dehumidification operations. To accelerate the schedule, the team developed an alternate method for testing the cables while fully sealed. This allowed the dehumidification to be removed off the critical path until closer to the end of the project. To switch traffic and begin operations on the west side of the bridge, the eastern cable dehumidification system needed to be fully signed off. As the dehumidification system was in fabrication when it came time to move to phase two, AB developed a temporary blower system that was set up to check that the eastern cable was fully sealed, without the need of the permanent dehumidification equipment to be in place.
Project Details
- Owner: Allegheny County Department of Public Works
- Location: Pittsburgh, Pennsylvania
- Project Value: $20M
- Completion Date: 2019
- Structure Type: Suspension Bridge
- Delivery Model: Rehabilitation
